Transportation Projects

Intersection Improvement Projects

The Town of Zebulon is experiencing rapid growth along several major corridors throughout town. As new neighborhoods are built and new residents move into our community, the increased traffic requires changes to our roadways to ease congestion and enable the safe, smooth movement of traffic. The Town is working with the NC Department of Transportation and various engineers, surveyors, contractors, and other firms to design and construct intersection improvements.



Green Pace Road/North Arendell Avenue

The growth in residential neighborhoods along Pippin Road is increasing the traffic at the intersection of Green Pace Road and North Arendell Avenue. A 2017 study by NCDOT indicated that a signal is warranted based on the traffic volumes and delays observed. In March of 2020, the Town of Zebulon hired an engineering firm to study the movements in the area between Green Pace Road, Riley Hill Road, and Proctor Street and to examine the various options for improving safety and traffic flow. The Town, engineers, and NCDOT ultimately decided to install a traffic light at Green Pace Road and North Arendell Avenue and to add turn lanes on North Arendell Avenue.

In October of 2020, the Town began designing the intersection, obtaining permits, and working with utilities in the area. The estimated construction cost is $1.3 million. Once construction is complete, NCDOT will take over all maintenance and repairs.

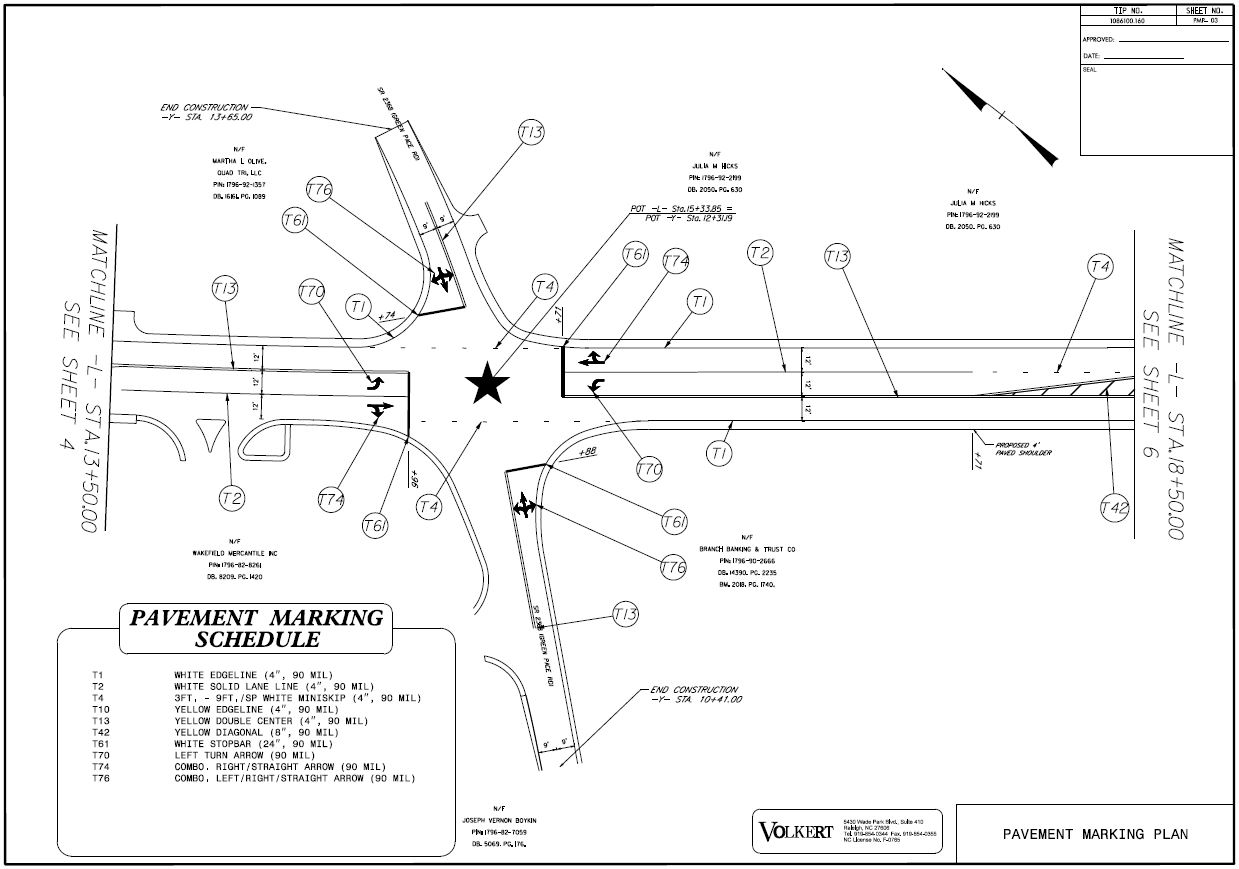

Plan view of intersection of Green Pace Road and Arendell Avenue

Click to expand



Project Timeline



PROJECT ACTIVITY

STATUS/ TIMEFRAME

Warrant Analysis (NCDOT)

COMPLETE - May 2017

Transportation Impact Study

COMPLETE - Mar 2020

Planning Discussions with NCDOT

COMPLETE - Aug 2020

Maintenance Agreement executed with NCDOT

COMPLETE - Aug 2020

Hire engineer for design, environmental permitting, surveying, utility coordination, & erosion control

COMPLETE - Oct 2020

Survey existing conditions and elevations

COMPLETE - Dec 2020

25% Construction plans completed

COMPLETE - Feb 2021

60% Construction plans completed

COMPLETE - Nov 2021

Obtain environmental permits

COMPLETE

Coordinate with utilities in project area

COMPLETE

100% Construction Plans approval by NCDOT

COMPLETE

Complete Bid Documents, Estimates, & Specs

COMPLETE

Contract for Construction

COMPLETE

Contract for Construction Administration/CEI Services

COMPLETE

Project Construction

ONGOING

Project Closeout

Winter 2023



Shepard School Road/Old Bunn Road/Proctor Street

One area of rapid growth is near the intersection of Shepard School Road and Old Bunn Road/Proctor Street. A traffic study conducted in January of 2020 indicated that the volume of traffic flowing through the intersection would necessitate a light once the new neighborhoods were fully built. While NCDOT has this project in its long-range plans, the Town of Zebulon is moving forward with funding and constructing the improvements now in recognition of the project's importance to the Zebulon community. Once completed, NCDOT will take over all maintenance and upkeep for the intersection, from the monthly power bills to future infrastructure repairs.

Beginning in November of 2020, the Town is working with consultants, NCDOT, and other state agencies to install turn lanes and traffic signals at this intersection. The final design will improve safety and the flow of traffic. The estimated construction cost is $1.7 million.

While the Town of Zebulon works to implement these improvements, which typically take 3-4 years from design to construction, NCDOT is installing an All Way Stop at this intersection to address safety concerns and traffic back-ups on Old Bunn Road and Proctor Street.



 Plan view of intersection improvements

 Click to expand



Project Timeline



PROJECT ACTIVITY

STATUS/ TIMEFRAME

Warrant Analysis

COMPLETE - Jan 2020

Planning discussions with NCDOT

COMPLETE - Fall 2020

Maintenance Agreement executed with NCDOT

COMPLETE - Jan 2021

Hire engineer for design, environmental permitting, surveying, utility coordination, & erosion control

COMPLETE - Nov 2020

Survey existing conditions and elevations

COMPLETE - Mar 2022

30% Construction plans approval from NCDOT

COMPLETE - April 2021

60% Construction plans approval from NCDOT

COMPLETE - Nov 2021

Obtain environmental permits

COMPLETE - Jan 2022

Secure buffer mitigation credits

COMPLETE - Jan 2022

Hire right-of-way (ROW) agent

COMPLETE - Mar 2022

Purchase Easements and ROW

ONGOING

Design water line relocations

ONGOING

100% Construction Plans approval by NCDOT

 Spring 2023

Complete Bid Documents, Estimates, & Specs

 Spring 2023

Contract for Construction

Fall 2023

Contract for Construction Administration/CEI Services

Fall 2023

Project Construction

Spring - Fall 2024

Project Closeout

Fall 2024
